Page 62 - 건축구조 Vol. 29 / No. 03
P. 62

Project focus    Compton and Edrich stands, Lord’s Cricket Ground


                해외작품소개

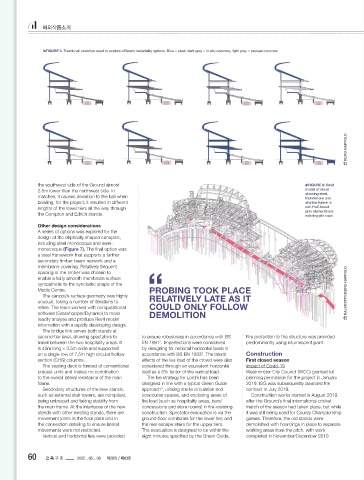

                FIGURE 5: Thumbnail sketches used to explore different materiality options. Blue = steel, dark grey = in situ concrete, light grey = precast concrete

















                                                                                                                         BURO HAPPOLD








              the southwest side of the Ground almost                                                     FIGURE 6: Revit
              2.5m lower than the northwest side. In                                                      model of stand
              matches, it causes deviation to the ball when                                               showing steel,
                                                                                                          foundations and
              bowling; for the project, it resulted in different                                          shallow tunnel in
              lengths of the lower tiers all the way through                                              red. Half-toned
              the Compton and Edrich stands.                                                              pink elements are
                                                                                                          existing pile caps
              Other design considerations
              A series of options was explored for the
              design of the elliptically shaped canopies,
              including steel monocoque and semi-
              monocoque (Figure 7). The final option was
              a steel framework that supports a further
              secondary timber beam network and a
              membrane covering. Relatively frequent
              spacing of the timber was chosen to
              enable a fairly smooth membrane surface
              sympathetic to the synclastic shape of the
              Media Centre.                         PROBING TOOK PLACE                                                   RAJ MISTRY/BURO HAPPOLD
                The canopy’s surface geometry was highly
              unusual, taking a number of iterations to   RELATIVELY LATE AS IT
              refine. The team worked with computational   COULD ONLY FOLLOW
              software (Grasshopper/Dynamo) to more
              readily analyse and produce Revit model   DEMOLITION
              information with a rapidly developing design.
                The bridge link serves both stands at
              second-tier level, allowing spectators to   to ensure robustness in accordance with BS   Fire protection to the structure was provided
              travel between the two hospitality areas. It   EN 1991 . Imperfections were considered   predominantly using intumescent paint.
                                                        2
              is 40m long × 3.5m wide and supported   by designing for notional horizontal loads in
              on a single row of 7.5m high circular hollow   accordance with BS EN 1993 . The lateral   Construction
                                                                      3
              section (CHS) columns.              effects of the live load of the crowd were also   First closed season
                The seating deck is formed of conventional   considered through an equivalent horizontal   Impact of Covid-19
              precast units and makes no contribution   load as a 5% factor of the vertical load.  Westminster City Council (WCC) granted full
              to the overall lateral resistance of the main   The fire strategy for Lord’s has been   planning permission for the project in January
              frame.                              designed in line with a typical Green Guide   2019. ISG was subsequently awarded the
                Secondary structures of the new stands,   approach , utilising sterile circulation and   contract in July 2019.
                                                        4
              such as external stair towers, are compliant,   concourse spaces, and enclosing areas of   Construction works started in August 2019
              being unbraced and taking stability from   fire load (such as hospitality areas, bars/  after the Ground’s final international cricket
              the main frame. At the interfaces of the new   concessions and store rooms) in fire-resisting   match of the season had taken place, but while
              stands with other existing stands, there are   construction. Spectator evacuation is via the   it was still being used for County Championship
              movement joints in the floor plate and in   ground-floor vomitories for the lower tier, and   games. Therefore, the old stands were
              the connection detailing to ensure lateral   the rear escape stairs for the upper tiers.   demolished with hoardings in place to separate
              movements were not restricted.      The evacuation is designed to be within the   working areas from the pitch, with work
                Vertical and horizontal ties were provided   eight minutes specified by the Green Guide.   completed in November/December 2019.


                                                                 30                                                                                                                     31
           60    건 축 구 조    2022 _ 05 _ 06   제29권 / 제03호  May 2022  |  thestructuralengineer.org                                                                               thestructuralengineer.org  |  May 2022


         Lords Cricket St_TSE May 2022_The Structural Engineer.indd   30                                           20/04/2022   09:50
