Project focus    Compton and Edrich stands, Lord’s Cricket Ground  Compton and Edrich stands, Lord’s Cricket Ground   Project focus


                                                          Design and construction of the Compton and Edrich stands, Lord’s Cricket Ground redevelopment


 FERGUS McCORMICK  beverage concessions, two new restaurants,   ground level, with the outer perimeter of the   alignment was at odds with the setting-out
 new washrooms and a high-level connecting   stands conceived as a lighter colonnade with   of the frames at the northern and southern
 MSt, MSc, MA, CEng, FIStructE, FICE
 walkway for improved crowd circulation.  slim columns. The structural framing of each   ends in a fan arrangement (Figure 6). The
 Partner, Buro Happold, Bath, UK
 In contrast to the previous stands, the top   stand developed to a moment frame solution in   superstructures of these northern and southern
 level is partially covered with a steel-framed roof,   each direction.         frames were all different and the variation was
 which complements the subtle curvature and   In the cross-section, the main part of the   compounded by their main bases all needing
 TIM SULLIVAN
 form of the design while creating a distinctive   main frames was generally supported on two   to be designed to miss the tunnel. There were
 IEng, AMIStructE  silhouette, helping to heighten the sense of   main columns with two further supports for the   seven special foundation scenarios transferring
 Technical Director, ISG, London, UK  drama of sporting events.  lower tier (Figure 3). The rear columns became   columns over the tunnel.
 A key requirement was to develop a coherent,   pin-ended, enabling a transparent welcoming   Further ground constraints included the
 integrated structural design and construction   elevation with a refined aesthetic; the lateral   substructure of two previous versions of the
 IAIN HILL
 strategy respecting the high-quality aesthetic   strength and stiffness was focused on an   stands on this part of the site, which were
 BEng, CEng, FIStructE, FICE  that the client and architect required.  inner main column coupled with the bending   shown on archive drawings. The previous
 Associate Director, Severfield, Bolton, UK  This article describes how Buro Happold   resistance of main grid-line rakers. Lateral   stand was founded on pads, but the new, taller
 considered all materiality for the frame design,   resistance in the longer directions was also from   development with its higher loads was founded
 before selecting steel after an extensive   moment action, with the main front column   on rotary auger-bored piles in London clay. Pile
 PAUL EDDLESTON
 construction programming study. The design   again providing the key strength and stiffness.  diameters were 600mm and 750mm. Despite
 MSc, BSc, CEng, MICE  diagram of the steel moment frame in each   The main supporting columns were some of    PAUL EDDLESTON/BURO HAPPOLD  the availability of records, the team decided that
 Senior Structural Engineer, Buro Happold, Bath, UK  direction was chosen to suit the required   the largest elements in each of the two stands:   FIGURE 3:   every pile location should be probed to mitigate
 openness, but the frame was designed with pin-  typically 1400mm × 500mm box sections, with   Framing diagram for   risk – a decision subsequently justified by the
        cross-section and
 ended columns on the outer perimeter to enable   100mm thick base plates fixed with Macalloy   fact that many probes located unexpected
 MICK SLACK  bending moment
 a light colonnade elevation and stiffer columns   bar anchor assemblies. There are nine of these   diagram against   obstructions that were not shown on the record
 BEng, CEng, MIStructE  on an inner line. The moment connections of the   columns in the Compton stand and seven in the   lateral loads  drawings. These locations required modified pile
 Engineering Manager, Severfield, Bolton, UK  frame were key details, with Severfield providing   Edrich stand. Positioned on grid line B, which      positions and special pile caps.
 important design input for the final choice.  is in the middle of each stand, the columns sit   The principal challenge was maintaining the
 The article also discusses some of the   towards the back of the lower tier, support the   Designing for programme  hosting of matches while increasing the ground   construction programme as these discoveries
 RAJAN MISTRY
 challenges of working within the existing site   7m cantilevering seating area of the second   Construction for sports projects within existing   capacity and operational efficiency to enhance   arose during the construction phase; probing
 BSc (Hons)  and the unprecedented demands imposed by   tier, and also support the underside of the   grounds needs to understand and respect   spectator experience. However, site constraints   took place relatively late as it could only follow
 Engineering Technician, Buro Happold, Bath, UK  Covid-19, explaining how ISG approached and   uppermost seating level.  the sports event calendar. This project was   and working within an operational site presented   demolition. During the peak of the piling, revised
 worked through these.  The steel section types, depths and   no exception and the schedule included   challenges. For this project, there were complex   designs, models, drawings and reinforcement
 Introduction  connections give a clear legibility to the framing   demanding quantities of work in each closed   interfaces with adjacent structures, but the   drawings needed to be produced very quickly,

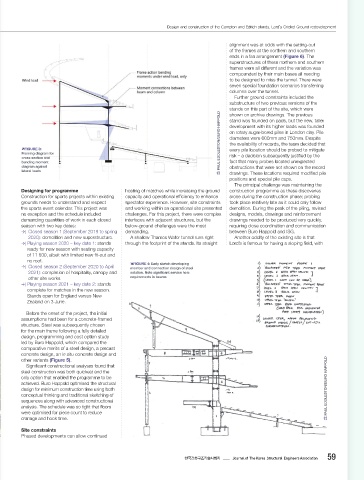

 Marylebone Cricket Club (MCC) has led the   Design challenges  diagram of the design (Figure 4). The lower   season with two key dates:  below-ground challenges were the most   requiring close coordination and communication
 game of cricket for over 200 years and helped   Design diagram  tier was not included in the radial lateral stability   |   Closed season 1 (September 2019 to spring   demanding.  between Buro Happold and ISG.
 take it from a national pastime in England to   The layout and organisation of floors and   system as a low-level prop, because of its   2020): demolition and new superstructure.  A shallow Thames Water tunnel runs right   Another oddity of the existing site is that
 a global obsession. At its heart is Lord’s, the   seating tiers responded to the functional needs   variable relationship to the main frame around   |  Playing season 2020 – key date 1: stands   through the footprint of the stands. Its straight   Lord’s is famous for having a sloping field, with
 ‘Home of Cricket’, where MCC is dedicated to   of the buildings, with the overall form and shape   the stands and because its optimum design   ready for new season with seating capacity
 growing its reputation as the most celebrated   developed to complement the JP Morgan   choice for construction was uncertain for some   of 11 600, albeit with limited new fit-out and
 venue in cricket. Lord’s has been at its current   Media Centre. Each stand, including its roof,   time. Eventually, the lowest part of the lower tier   no roof.
 location in St John’s Wood, northwest London   was spatially offset from the Media Centre to   was generally formed of in situ concrete and the   |   Closed season 2 (September 2020 to April   FIGURE 4: Early sketch developing
                                              member and connection design of steel
 for over 200 years.  allow each part of the new elevation to be read   whole of the tier was laterally isolated from the   2021): completion of hospitality, canopy and   solution. Note significant service hole
 Responding to an increasingly competitive   individually, but also so that all three separate   remainder of the main frame.  other site works.  requirements in beams
 sporting environment, the Ground has   building blocks – the Compton stand, the Edrich   The frame was designed to the dynamic   |  Playing season 2021 – key date 2: stands
 been undergoing upgrade work to steadily   stand and the Media Centre – could be read as   criteria and method of the IStructE guide .   complete for matches in the new season.
 1
 improve facilities in accordance with a staged   a single new composition.  The cantilevers are long, but the frame is not   Stands open for England versus New
 masterplan. MCC Chief Executive and   The key structural design challenge was   designed for concert events, which significantly   Zealand on 3 June.
 Secretary, Guy Lavender, has stated: ‘MCC is   to maintain a light, airy feeling to the whole   reduces the spectator excitation and, hence,
 committed to ensuring Lord’s remains the best   development and very open circulation at   demand on the cantilevers.  Before the onset of the project, the initial
 place in the world at which to watch and play   assumptions had been for a concrete-framed
 cricket.’  structure. Steel was subsequently chosen
 The latest phase of the masterplan   for the main frame following a fully detailed
 encompasses redevelopment of the Compton   FIGURE 2: View from Nursery   design, programming and cost option study
 Ground (west) during later stages
 and Edrich stands, which are situated either   of construction showing new   led by Buro Happold, which compared the
 side of the distinctive aluminium JP Morgan   stands, either side of JP Morgan   comparative merits of a steel design, a precast
 Media Centre at the famous Nursery End of   Media Centre  concrete design, an in situ concrete design and
 the Ground (Figure 1). The previous stands   other variants (Figure 5).
 were dated and lacking in facilities. The new   Significant constructional analyses found that
 stands transform the Nursery End, providing   steel construction was both quickest and the
 world-class facilities, opening up views both   only option that enabled the programme to be
 to the Pavilion and back towards the Nursery   achieved. Buro Happold optimised the structural
 Ground (Figure 2), and adding another design   design for minimum construction time using both                   PAUL EDDLESTON/BURO HAPPOLD
 enhancement to Lord’s.  conceptual thinking and traditional sketching of
 A three-tier arrangement takes the capacity   sequences along with advanced constructional
 of the new stands from 9000 to 11 600 seats,    STEVE MACEY/BURO HAPPOLD  analysis. The schedule was so tight that floors
 accompanied by two new main sponsor   were optimised for piece count to reduce
 boxes. There are new wheelchair spaces,   cranage and hook time.
 additional accessible seating exceeding
 industry best practice, and modern associated   Site constraints
 amenities. Other features include food and   Phased developments can allow continued


 28                                                         29
 28
 May 2022  |  thestructuralengineer.org           thestructuralengineer.org  |  May 2022  Journal of  The Korea  Structural  Engineers Association  59
